Anjou

Construction of the Anjou station



Construction site summary

As part of the Blue line project, this worksite involves building a new accessible métro station with two entrance buildings on each side of Highway 25, and a bus terminal. The two entrance buildings will be connected by a pedestrian walkway under autoroute Louis-Hippolyte-La Fontaine (A-25). It will be open to the public and no fare will be needed to cross from one side to the other.The entire extension is expected to be commissioned in 2031

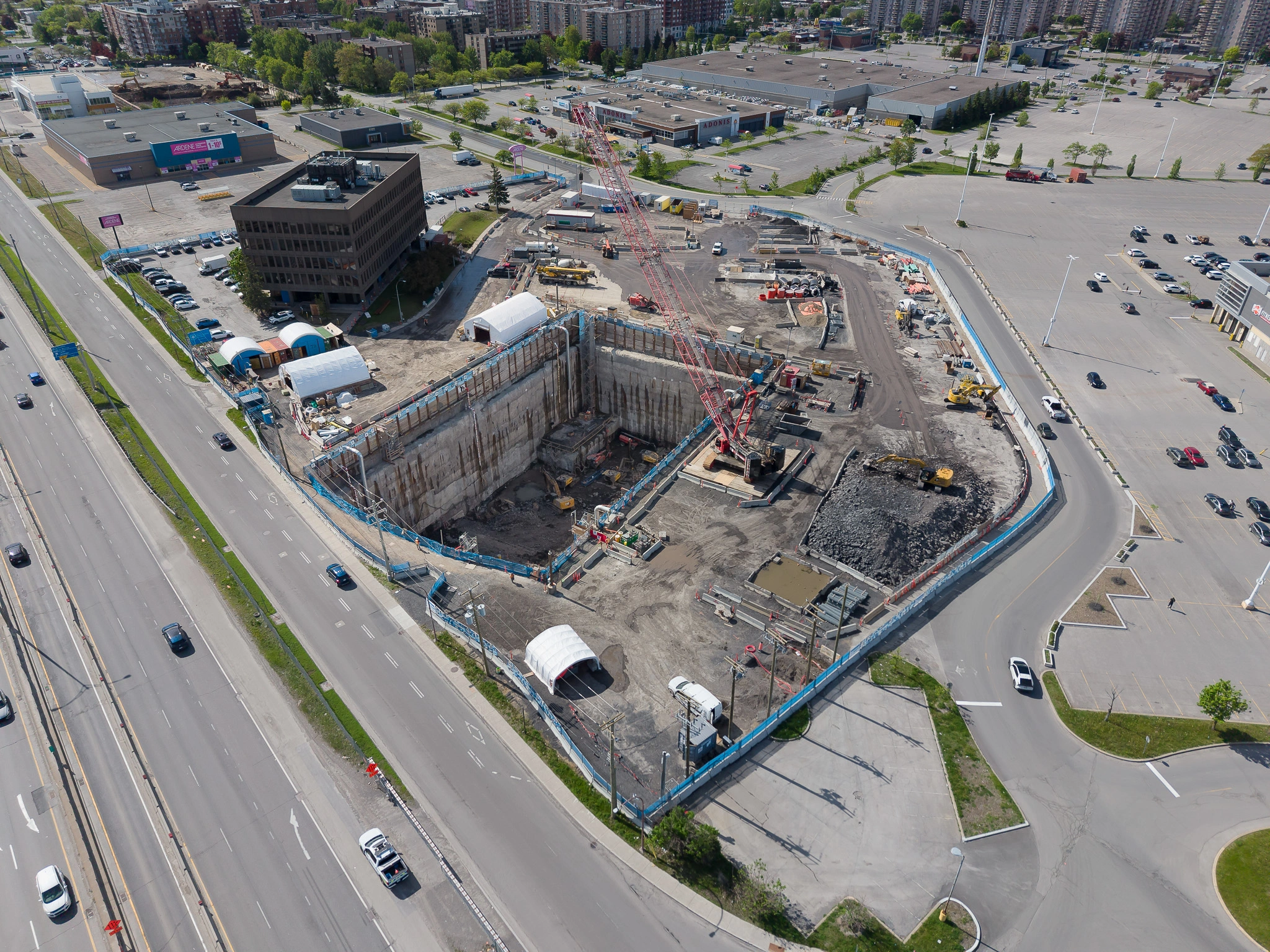

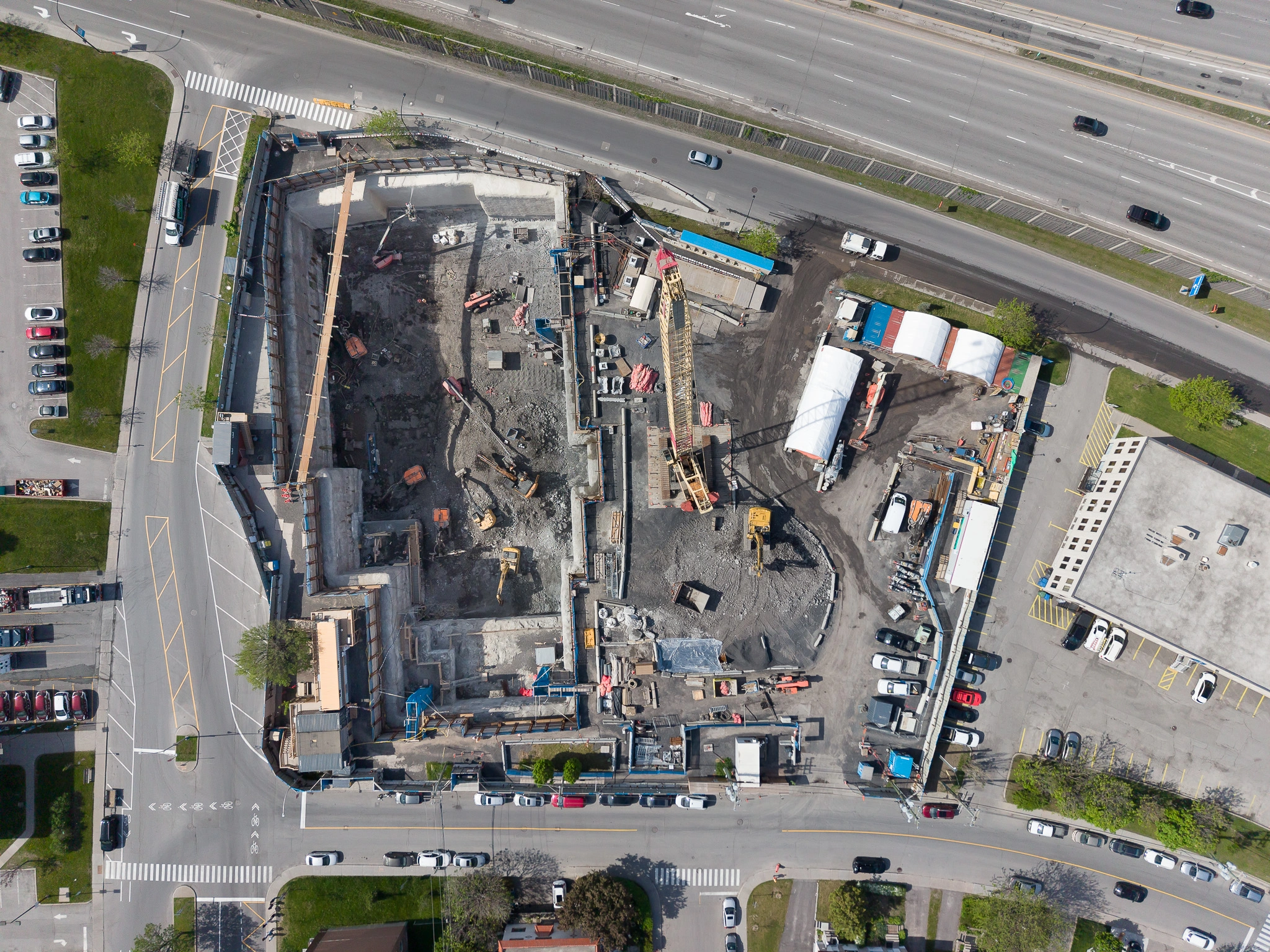

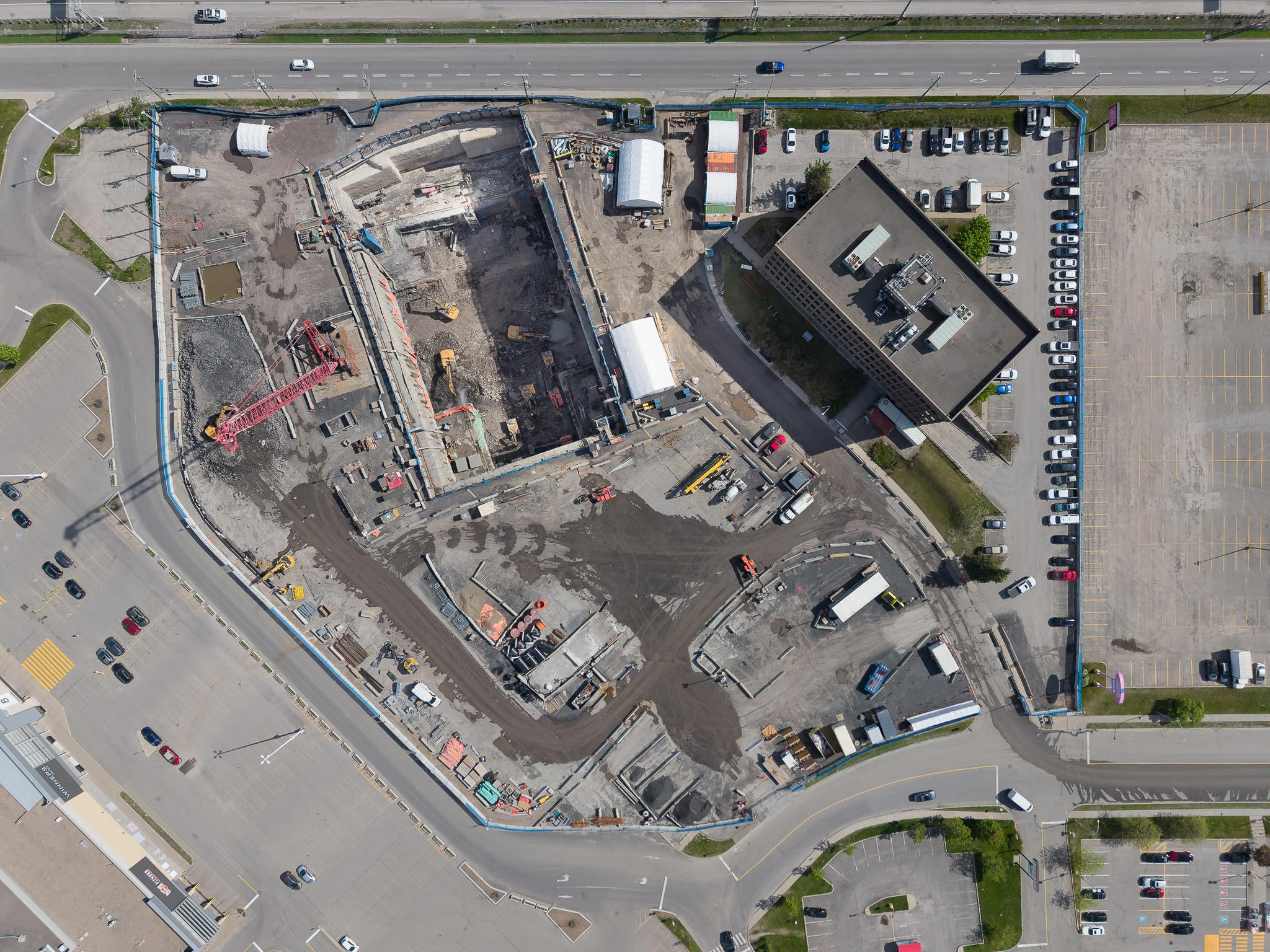

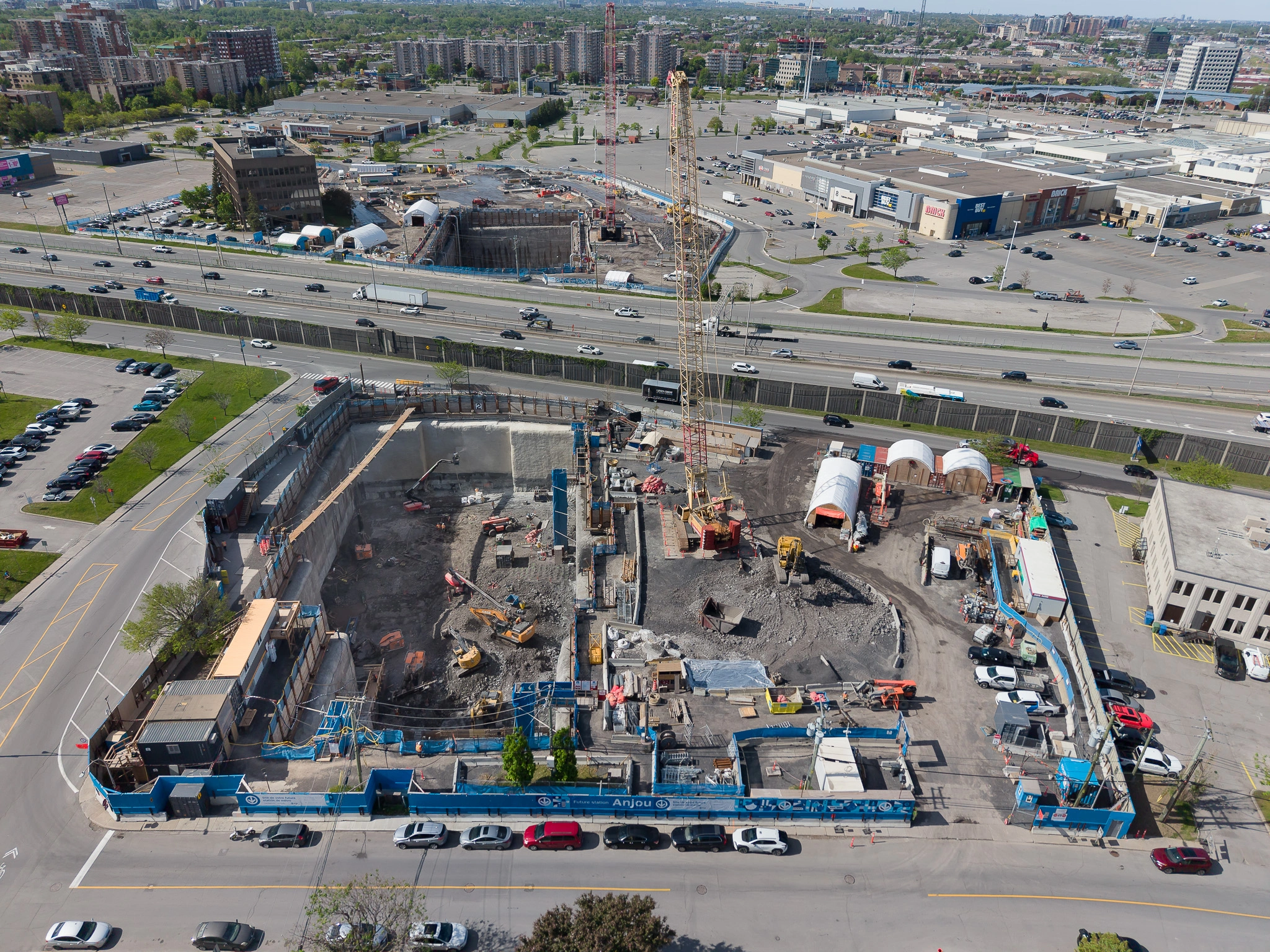

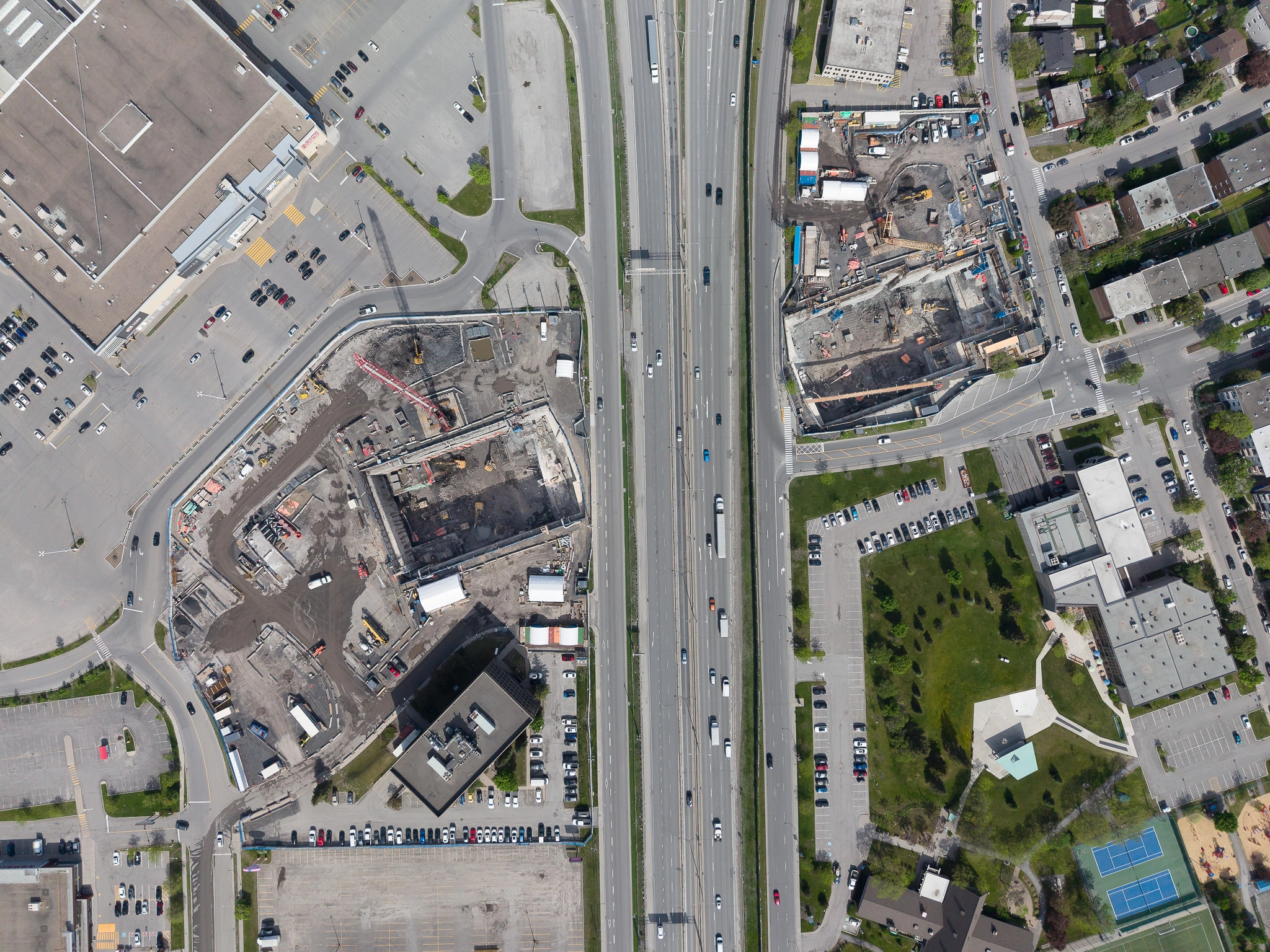

Current step: Vertical excavation of both sites of the station.

Building an underground infrastructure of this scale requires a tremendous amount of work. Here are the main steps required to build the future station:

Step
Status
Preparatory work (relocation of underground water mains, sewers and cabling)
Completed
Mobilization and site setup
Completed
Vertical excavation of both sites of the station
In progress
Horizontal excavation of the vault for the boarding platforms and the tunnel entrance
Upcoming step
Shotcrete applied to the walls of the boarding platforms vault and the tunnel entrance
Upcoming step
Tunnel boring machine work to excavate and line most of the tunnel
Upcoming step
Concreting and construction of new infrastructures
Upcoming step
Installation of finishing materials, linings and other architectural elements
Upcoming step
Installation of mechanical and electrical equipment
Upcoming step
Installation of track system and rails
Upcoming step
Exterior design and landscaping
Upcoming step
Testing and commissioning of equipment
Upcoming step

Impact on customer trips

  • The bus stop for route 141 - Jean-Talon, located on de Châteauneuf, has been relocated to the northeast corner of the intersection with avenue de Bourgneuf.
  • The stop on boulevard L.-H.-Lafontaine along the construction site has been cancelled.

Impact on local residents

The work is currently underway on two sites, located on either side of Highway 25. Partial street closures are expected.

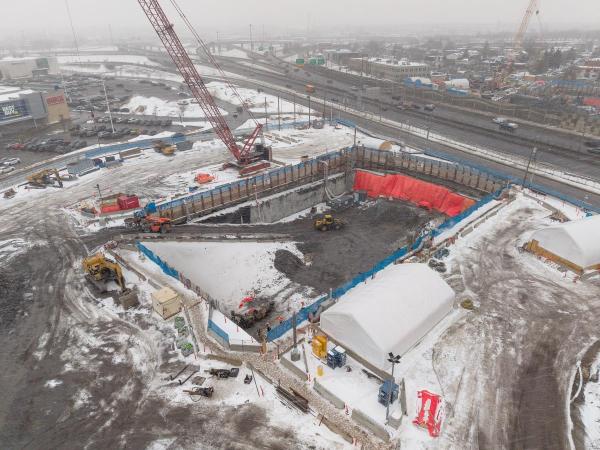

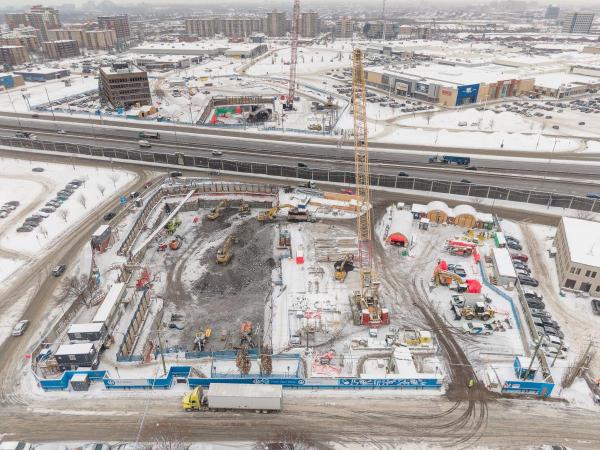

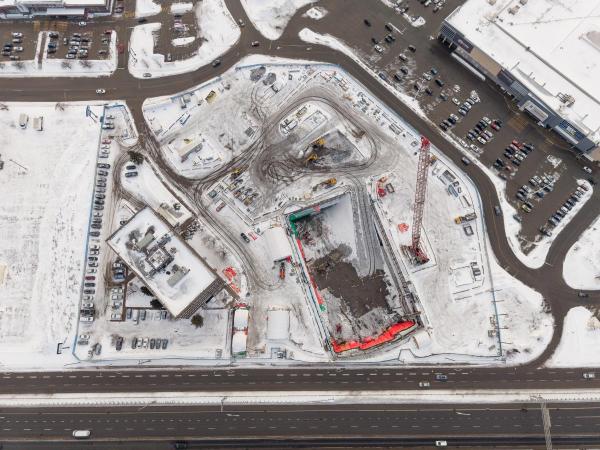

The rock excavation phase is currently underway in both the West and East sectors of the future Anjou station worksite.

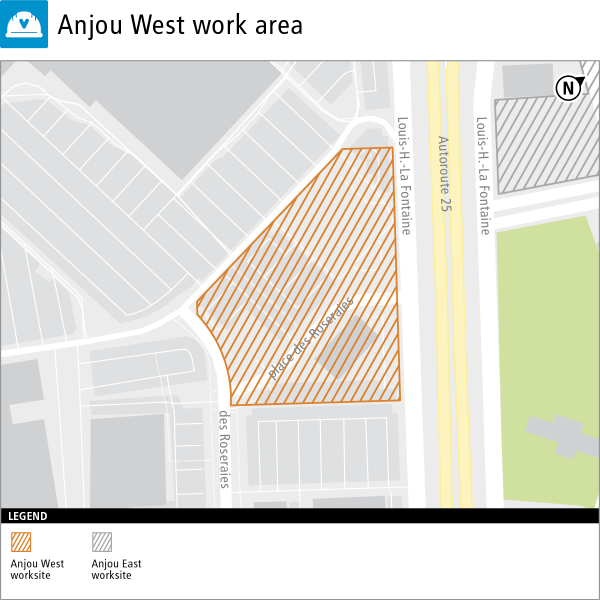

Anjou West

  • We have completely closed Place des Roseraies between Louis-H.-Lafontaine and Des Roseraies boulevards. This configuration will remain in place for several years.

Anjou East

Since May 2025:

  • We have completed the final setup of the construction site. We have installed concrete barriers and noise barriers along de Bourgneuf Avenue and de Châteauneuf Boulevard to reduce noise and dust for nearby residents. This configuration will remain in place for several years.
  • Sidewalks along the worksite are closed. Walkways have been set up to allow pedestrians to get around the site safely.
  • On Châteauneuf Boulevard, one traffic lane will remain open in each direction for the duration of the work.
  • Truck routes have been determined to limit traffic near pedestrian corridors. Service roads are primarily being used.

Cranes are in place in the West and East sectors.

  • The crane is an electric model, which creates less noise than the diesel-powered mobile cranes and produces no exhaust gas.
  • The crane will not be used when weather conditions are unfavourable.
  • When not in use, the crane will be left in “weathervane mode,” allowing it to pivot freely on its axis in strong winds. If you see the crane turning while the worksite is closed, this is normal!
  • The crane is equipped with a “zoning system.” This electronic system allows the crane to be programmed with boundaries that stop it from lifting or moving a load into preset zones. The boundaries is applied to the entire perimeter of the worksite to ensure that no lifting takes place over nearby residences or public areas. If lifting in a public area is necessary, a safety perimeter will be set up with a flagger present to redirect the flow of pedestrians and vehicles.
